Timeline Slides in PowerPoint: Complete Guide for Consultants
Learn how to create professional timeline slides in PowerPoint. Covers linear, milestone, Gantt, and swimlane timelines with templates, best practices, and add-in options.
A timeline slide shows events, phases, or milestones arranged chronologically. It answers the fundamental question every stakeholder asks: "What happens when?" Unlike project plans buried in spreadsheet rows, a timeline slide communicates project structure visually so executives can absorb it in seconds.
This guide covers the four timeline types, best practices from MBB consulting, common mistakes, and how to create timelines efficiently. For a complete overview of all chart types used in consulting presentations, see our PowerPoint Charts Guide.
Get the Template: Download our free Timeline PowerPoint Template with horizontal and vertical layouts, milestone markers, and roadmap variants.
What Is a Timeline Slide?#
| Element | Purpose |
|---|---|
| Horizontal axis | Shows time progression (days, weeks, months, quarters) |
| Bars or markers | Represent activities, phases, or events |
| Milestones | Highlight key dates and deliverables |
| Labels | Identify what each element represents |
| Color coding | Groups related items or shows status |
The best timeline slides balance completeness with clarity—enough information for stakeholders to understand the plan, but not so much that the slide becomes overwhelming.

When to Use Timeline Slides#
Timeline slides appear constantly in consulting presentations: project kickoffs, steering committee updates, implementation roadmaps, and strategic plans. The most common use cases include:
- Project kickoffs: Show major phases, key milestones, client touchpoints, and overall duration to build confidence that the team has a plan.
- Executive status updates: Add a "today" marker so steering committees can instantly see progress against plan.
- Implementation roadmaps: Display parallel workstreams, dependencies, and go-live dates for complex programs.
- Strategy presentations: Communicate multi-year transformation journeys focused on capability building and value realization.
- Product roadmaps: Show feature releases, platform milestones, and technology transitions.
When NOT to Use Timelines#
| Don't Use Timeline When | Use Instead |
|---|---|
| Showing a single point-in-time snapshot | Dashboard or status slide |
| Comparing multiple options side-by-side | Decision matrix or comparison table |
| Displaying hierarchical relationships | Org chart or tree diagram |
| Items have no time dimension | Process flow or framework diagram |

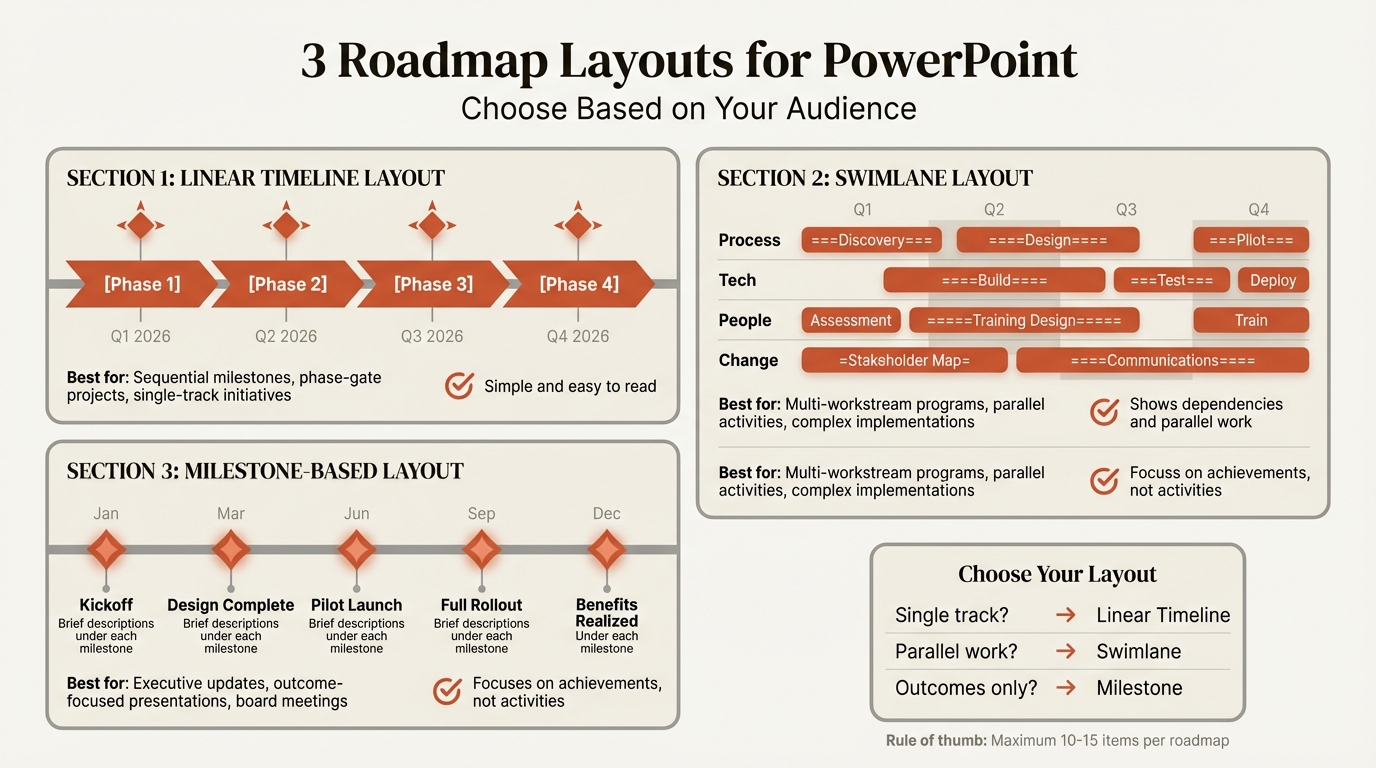

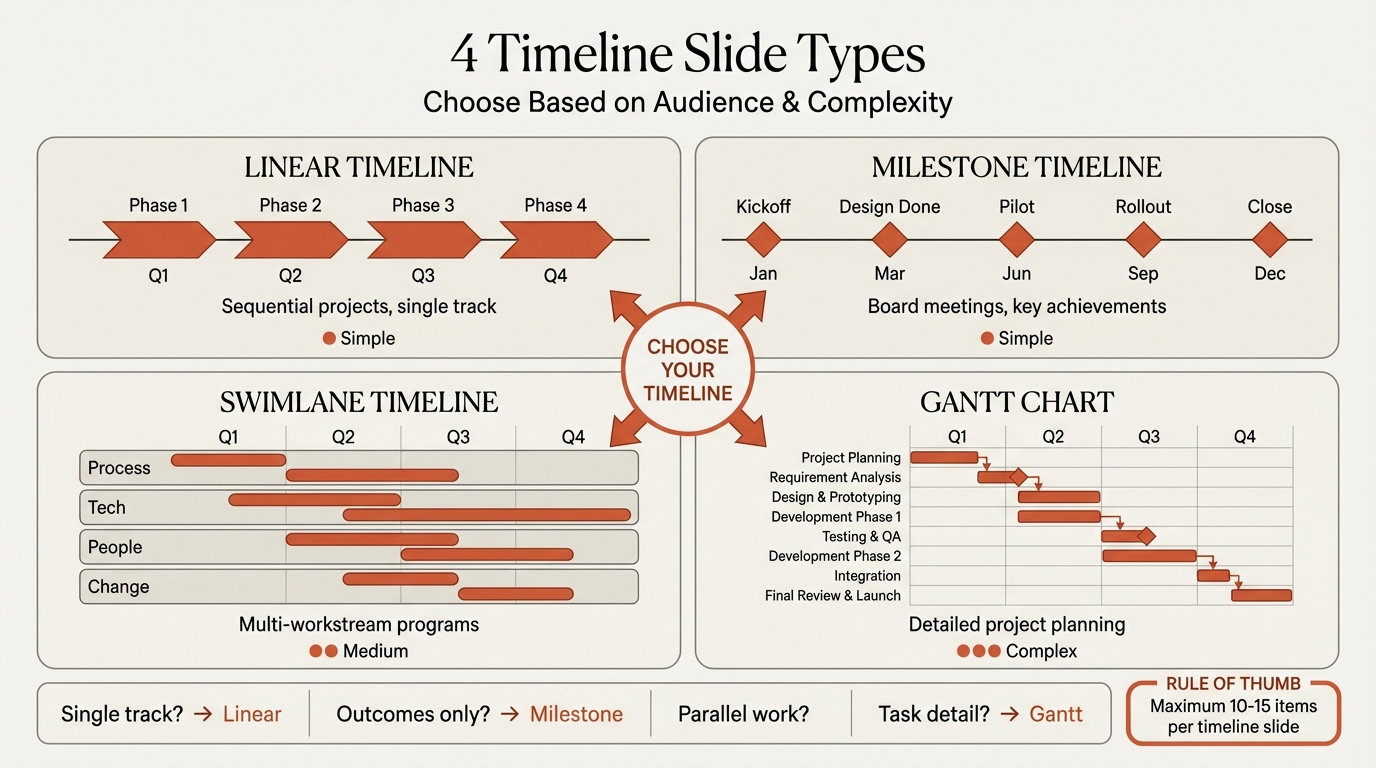

Types of Timeline Slides#

Different situations call for different timeline formats. Here are the four types consultants use most frequently.
Linear Timeline#
Events or phases arranged sequentially along a horizontal line. Best for simple sequential projects, company history slides, and executive summaries where you need the "elevator pitch" version of your timeline. Cannot show parallel activities or varying durations.
Milestone Timeline#
Emphasizes specific dates and achievements rather than continuous activities. Best for board presentations, contract deadlines, and launch-oriented presentations. Answers the executive question: "What will we see and when?"
Swimlane Timeline#
Stacks multiple parallel workstreams vertically along the same horizontal axis. This is the consulting workhorse—it shows how workstreams progress together, where dependencies exist, and how pieces integrate. Best for multi-workstream transformations and cross-functional initiatives.
Gantt Chart Timeline#

The most detailed format, showing specific task durations with precise start and end dates. Gantt charts include dependency arrows and can show hundreds of tasks. Best for PMO reporting and implementation teams—keep these in appendix slides rather than executive summaries.
Continue reading: 30-60-90 Day Plan Template · Agile vs Waterfall · Best Fonts for PowerPoint
Better charts for PowerPoint
Waterfall, Mekko, Gantt — build consulting-grade charts in seconds. Link to Excel for automatic updates.
Timeline Slide Best Practices#
Match Granularity to Audience#
| Audience | Granularity | Items | Time Scale |
|---|---|---|---|
| Board/C-suite | Strategic phases | 4-6 | Quarters/Years |
| Steering committee | Major workstreams | 8-12 | Months/Quarters |
| Project managers | Detailed tasks | 15-30 | Weeks/Months |
| Implementation team | Full task list | 30+ | Days/Weeks |
Choose the Right Time Scale#
| Project Duration | Recommended Scale | Gridlines |
|---|---|---|
| 1-4 weeks | Days | Daily or every 2 days |
| 1-3 months | Weeks | Weekly |
| 3-12 months | Months | Monthly |
| 1-3 years | Quarters | Quarterly |
| 3+ years | Years/Halves | Annually |
Keep It Focused#
Limit items to 10-15 maximum. The human brain effectively tracks 5-7 chunks of information, and beyond 15 items comprehension drops sharply. If your timeline has more detail, group related activities and put the rest in an appendix.
Use color strategically to create visual hierarchy—different colors for workstreams (limit to 5-6), filled bars for completed items, outlined bars for future work, and a consistent accent color for milestones. Avoid rainbow timelines where every item is a different color.
Include 3-5 Clear Milestones#
Milestones anchor executive attention. Make them specific and verifiable ("System go-live" not "Progress made"), dated explicitly ("March 15" not "mid-Q1"), and placed at decision points, deliverables, or external deadlines. Without milestones, timelines are just bars on a line.
Common Timeline Mistakes#
| Mistake | Why It Fails | Fix |
|---|---|---|
| Using SmartArt for complex projects | Cannot show parallel activities or varying durations | Use swimlane layouts or add-ins for multi-workstream timelines |
| Too much detail | Executives lose the thread and can't identify what matters | Limit to 10-15 items; put detailed schedules in the appendix |
| Missing milestones | Doesn't answer "What will we see and when?" | Add 3-5 milestone markers at key dates |
| Wrong time scale | Daily scale for a 2-year program becomes unreadable | Match scale to project duration (see table above) |
| No visual hierarchy | When everything looks equal, nothing stands out | Make major phases more prominent; differentiate milestones from activities |
| Static charts that can't update | Teams present outdated plans rather than fight with PowerPoint | Use tools with Excel linking like Deckary |
| Ambiguous dates | "Q2" without the year undermines trust months later | Always include the year; use explicit dates for milestones |
How to Create Timeline Slides in PowerPoint#
You have three options, each with different trade-offs.
SmartArt Graphics (5-15 min): Go to Insert > SmartArt > Process and choose Basic Timeline or Circle Accent Timeline. Fast and built-in, but limited to sequential items with no Excel linking. Best for simple 5-8 item timelines.
Manual Shapes (30-60 min): Build from scratch using rectangles, lines, and diamonds. Full design control, but time-consuming to create and painful to update. Best for one-time timelines with specific design requirements.
PowerPoint Add-ins (5-10 min): Tools like Deckary and Office Timeline create professional timelines from Excel data with automatic updates. Best for consulting deliverables and presentations that need regular updates.
Method Comparison#
| Feature | SmartArt | Manual Shapes | Deckary | Office Timeline |
|---|---|---|---|---|
| Time to create | 5-15 min | 30-60 min | 5-10 min | 5-15 min |
| Time to update | 5-10 min | 20-30 min | 30 sec | 2-5 min |
| Excel linking | No | No | Yes | Yes (Pro) |
| Parallel activities | No | Yes | Yes | Yes |
| Milestones | Limited | Manual | Yes | Yes |
| Mac support | Yes | Yes | Yes | Yes |
| Price | Free | Free | $49-119/yr | $0-199/yr |

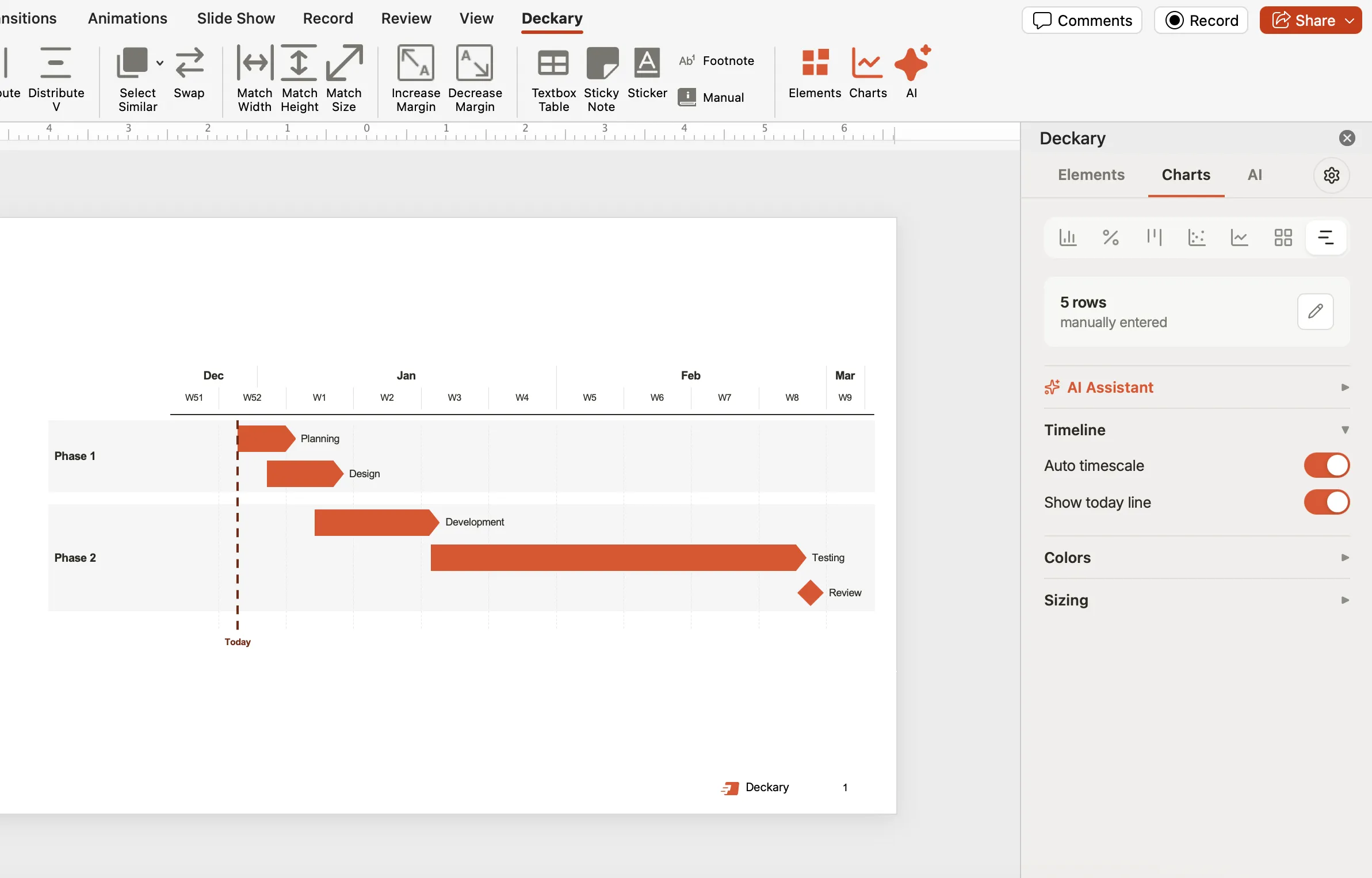

Creating a Project Timeline in Deckary#
Here's how to build a standard project timeline using Deckary's Gantt chart feature.
| Workstream | Activity | Start Date | End Date |
|---|---|---|---|
| Discovery | Stakeholder Interviews | Jan 6 | Jan 24 |
| Discovery | Current State Analysis | Jan 13 | Feb 7 |
| Design | Solution Design | Feb 10 | Mar 14 |
| Design | Process Mapping | Feb 24 | Mar 21 |
| Build | Development Sprint 1 | Mar 24 | Apr 11 |
| Build | Development Sprint 2 | Apr 14 | May 2 |
| Test | Integration Testing | May 5 | May 16 |
| Test | User Acceptance Testing | May 19 | May 30 |
| Deploy | Training | Jun 2 | Jun 13 |
| Deploy | Go-Live | Jun 16 | Jun 16 |
Prepare this data in Excel, select the range, and click "Gantt" in the Deckary ribbon. Drag onto your slide, adjust the time scale, set workstream colors, add milestones, and toggle the today marker for status presentations. The entire process takes 5-10 minutes—compared to 45+ minutes building the same timeline manually with shapes. When the inevitable "move Phase 2 back a week" request arrives, updates take 30 seconds versus 20+ minutes.
Timeline Templates and Resources#
| Source | What They Offer | Price |
|---|---|---|
| Microsoft Office | Built-in SmartArt + File > New templates | Free |
| Office Timeline | 50+ professional templates | Free basic, $108-249/yr paid |
| SlideModel | 250+ editable timeline designs | Subscription |
| PresentationGo | 63 free timeline templates | Free |
| Slideworks | MBB-style consulting templates | Premium |
For MBB-style templates matching the formatting standards used at top firms, Slideworks offers consulting toolkit packages created by ex-consultants.
Timeline Slide Checklist#
Before presenting, verify your timeline meets these standards:
- 10-15 items maximum with clear phase names
- 3-5 key milestones with specific, dated deliverables
- Appropriate detail level for your audience
- Action title that states the takeaway (not just "Timeline")
- Time scale matched to project duration
- Strategic color use for grouping and hierarchy
- All dates include the year
- "Today" marker included for status presentations
- Source data accessible for future updates
- Detailed schedule available in appendix if needed
Timeline slides transform complex project plans into visual narratives that executives understand in seconds. Choose the right type for your situation, match granularity to your audience, include clear milestones, and use tools with Excel linking so your timelines stay current. Explore Deckary's timeline and Gantt chart feature for professional timelines with automatic date handling. Master the timeline slide, and you've mastered one of consulting's most essential visual tools.
