What Is a Gantt Chart?#
A Gantt chart is a horizontal bar chart that visualizes a project schedule. Each bar represents a task, with its position showing when the task starts and its length showing duration.
| Element | What It Shows |
|---|---|
| Horizontal bars | Task duration (start to end) |
| Vertical axis | List of tasks or workstreams |
| Horizontal axis | Timeline (days, weeks, months) |
| Milestones | Key dates or deliverables (often diamonds) |
| Dependencies | Which tasks must complete before others start |

When to Use Gantt Charts#
Gantt charts work best in three scenarios: communicating project timelines to executives who need the overall picture at a glance, showing task dependencies and critical path for implementations and launches, and tracking progress against plan with a "today" marker in status meetings.
| Don't Use When | Use Instead |
|---|---|
| Showing high-level strategy phases only | Simple timeline or roadmap |
| Tasks have no time dimension | Org chart or hierarchy diagram |
| Comparing multiple project options | Table or decision matrix |
| More than 20 tasks | Summarized version + appendix detail |
Gantt Chart Best Practices#
Choose the Right Time Scale#
| Project Duration | Recommended Scale |
|---|---|
| 1-4 weeks | Days |
| 1-3 months | Weeks |
| 3-12 months | Weeks or Months |
| 1+ years | Months or Quarters |
Keep Tasks to 10-15 Maximum#
Group related activities rather than listing every sub-task:
| Too Granular | Better Grouping |
|---|---|
| Conduct user interviews, Analyze notes, Create personas... | Discovery & Research (4 weeks) |
| Install servers, Configure network, Deploy app... | Technical Setup (3 weeks) |
The detailed breakdown belongs in your project plan, not your executive presentation.
Use Color and Milestones Strategically#
| Element | Recommended Approach |
|---|---|
| Different workstreams | Different colors (limit to 5-6) |
| Completed tasks | Filled/solid bars |
| Future tasks | Outlined or lighter shade |
| Milestones | Diamonds at key dates (go-live, deliverables, decisions) |
| Critical path | Bold or highlighted color |
For status presentations, always add a vertical "today" marker — it instantly answers "Where are we?"

Continue reading: 30-60-90 Day Plan Template · Agile vs Waterfall · Best Fonts for PowerPoint
Better charts for PowerPoint
Waterfall, Mekko, Gantt — build consulting-grade charts in seconds. Link to Excel for automatic updates.
Method 1: Stacked Bar Chart Workaround (Native PowerPoint)#
The classic workaround uses a stacked bar chart with an invisible "start" series to position task bars.
Time required: 30-45 minutes for creation, 15-20 minutes per update
Step 1: Prepare Your Data
| Task | Start Day | Duration |
|---|---|---|
| Phase 1: Discovery | 0 | 14 |
| Phase 2: Design | 14 | 21 |
| Phase 3: Build | 35 | 28 |
| Phase 4: Test | 63 | 14 |
| Phase 5: Deploy | 77 | 7 |
Step 2: Go to Insert > Chart > Bar > Stacked Bar. Enter your data in the Excel sheet that opens.
Step 3: Click the Start series bars, right-click > Format Data Series. Set Fill to "No fill" and Border to "No line."
Step 4: Right-click the horizontal axis > Format Axis. Set minimum to 0, maximum to your project length.
Step 5: Click the vertical axis > Format Axis > check "Categories in reverse order."
Step 6: Adjust bar colors, manually add milestone diamonds using shapes, and add a "today" marker line.
Limitations: No automatic date calculation, updates require recalculating all start positions, and no dependency lines or Excel linking. A simple request to "move Phase 2 back two weeks" means recalculating every subsequent phase manually.
Best for: One-time Gantt charts that will not need updates.
Method 2: SmartArt Timeline (Native PowerPoint)#
For simple timelines without overlapping tasks, SmartArt offers a faster native option.
Time required: 10-15 minutes
- Go to Insert > SmartArt > Process > "Basic Timeline"
- Enter milestone names or phase titles in placeholders
- Use SmartArt Design tab to change colors and add date labels
Limitations: Cannot show overlapping tasks, no duration bars, limited customization, and no Excel linking.
Best for: Simple milestone timelines with 5-8 sequential items.
Method 3: PowerPoint Add-ins#
Add-ins like Deckary and Office Timeline are purpose-built for professional Gantt charts.
Time required: 2-5 minutes

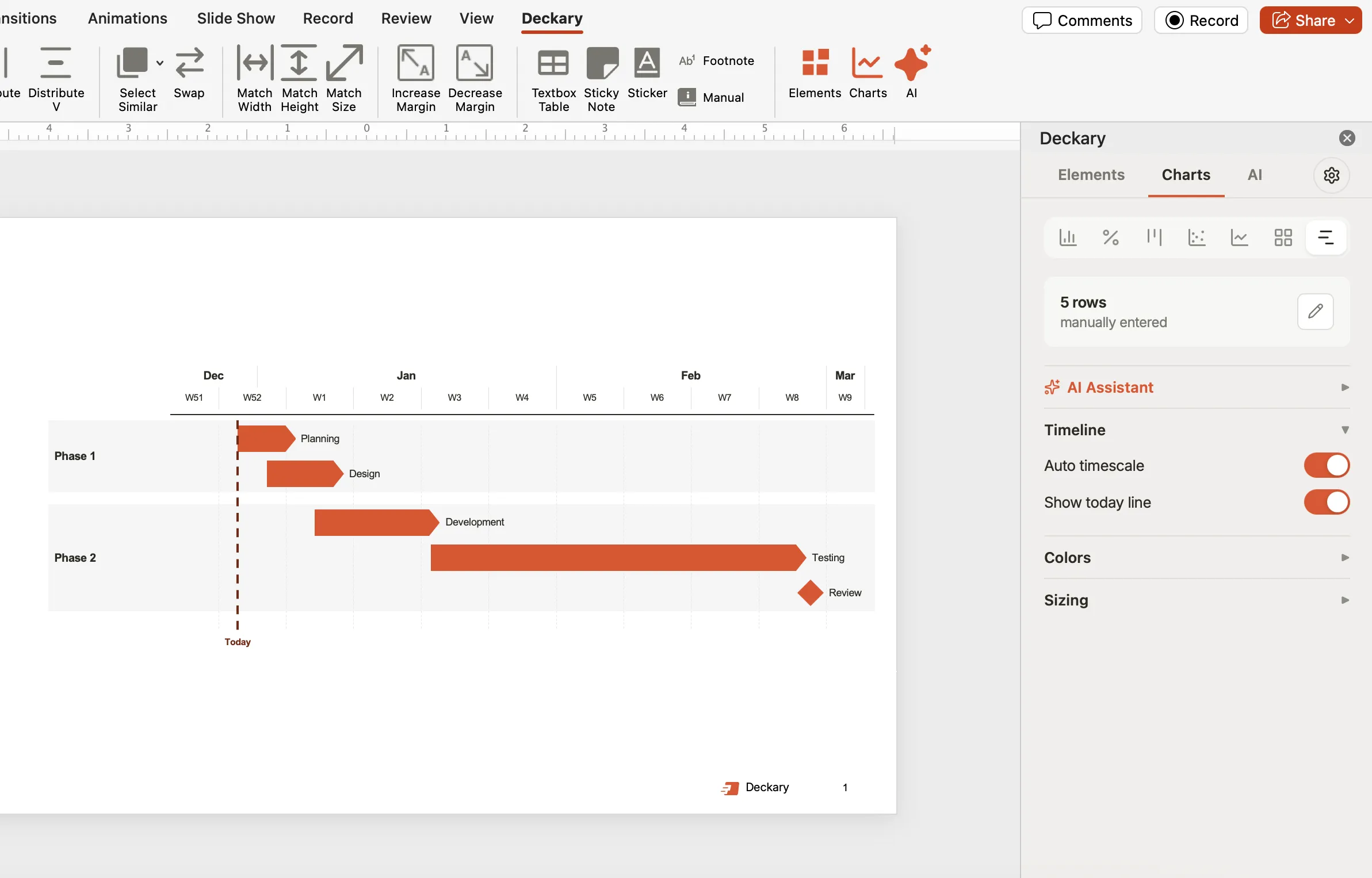

Deckary#
Deckary creates Gantt charts directly from your data with automatic date handling and formatting. Select your task data in Excel, click "Gantt" in the Deckary ribbon, and drag the chart onto your slide. Features include automatic date scaling, milestone markers, workstream grouping, live Excel linking, and cross-platform support.
Price: $49/year (Starter), $119/year (Premium), $199 lifetime
Office Timeline#
A dedicated timeline and Gantt chart add-in with a template library and import from Excel/Project/Smartsheet.
Price: Free basic version, $59/year Pro, $199/year Pro+
Method Comparison Table#
| Feature | Stacked Bar | SmartArt | Deckary | Office Timeline |
|---|---|---|---|---|
| Time to create | 30-45 min | 10-15 min | 2-5 min | 5-10 min |
| Time to update | 15-20 min | 5-10 min | 30 sec | 2-3 min |
| Excel linking | No | No | Yes | Yes (Pro) |
| Overlapping tasks | Yes | No | Yes | Yes |
| Milestones | Manual | Limited | Yes | Yes |
| Mac support | Yes | Yes | Yes | Yes |
| Price | Free | Free | $49-119/yr | $0-199/yr |
Which Method Should You Use?#
Choose Stacked Bar Workaround if: No budget, one-time chart, fewer than 10 tasks, 30+ minutes available.
Choose SmartArt Timeline if: Simple milestone timeline needed, tasks are sequential, 5-8 items maximum.
Choose Deckary if: Professional Gantt charts needed regularly, data lives in Excel and changes frequently, budget matters ($49-119/year vs $300+), need other chart types too.
Choose Office Timeline if: You only need timeline/Gantt functionality and want project management tool integration.
Gantt Chart Checklist#
Before presenting, verify:
Data Accuracy
- All dates are correct and realistic
- Dependencies make logical sense
- Milestones are placed at correct dates
Visual Clarity
- Timeline scale matches project duration
- Tasks limited to 10-15 items
- Workstreams color-coded consistently
- "Today" marker included for status presentations
Formatting
- Bars aligned and evenly spaced
- Legend explains color coding
- Font size legible when projected
Summary#
Gantt charts are the standard for project timeline visualization. When built correctly, they communicate complex schedules in seconds.
Key takeaways:
- PowerPoint has no native Gantt chart — use workarounds or add-ins
- Match granularity to audience — executives need summary views, not 50-task details
- Limit tasks to 10-15 — group related activities, put details in appendix
- Include milestones — key dates matter more than task details
- Choose the right tool:
- One-time chart: Stacked bar workaround
- Simple timeline: SmartArt
- Professional recurring charts: Deckary
- Plan for updates — if dates will change, use Excel-linked add-ins
For consultants building Gantt charts regularly, the right tools matter. A chart that should take 3 minutes should not take 45 — and when the partner asks to "move Phase 2 back two weeks," you should be able to do it in seconds. Explore Deckary's timeline and Gantt chart capabilities with Excel linking and automatic date handling.
